Structural Engineer Scope of Services: A Complete Guide

A structural scope explains who will resolve the next question

A structural engineer's scope of services identifies the work the engineer agrees to perform, the information needed to perform it, the expected deliverables and the boundaries of that responsibility. It should also explain how additional work and services provided by others will be handled.

That definition becomes practical when a project team asks about a product. A manufacturer may provide an evaluation report, connection data and installation details, yet the engineer still needs to determine whether the proposed system suits the building. Who checks the supporting construction? Who designs the connection? Who reviews a later substitution? A product package cannot answer those responsibility questions by itself.

For a structural-product technical support leader, understanding engineering scope helps make that package more useful. For an owner planning a home, addition or rebuild, it helps compare proposals on the work included rather than the fee alone. Both need a clear distinction between product expertise, project design and construction verification.

The aim is a coordinated assignment of work. A longer agreement is not necessarily a better one; a precise agreement makes important questions visible before the team relies on assumptions.

What the agreement should define

A useful scope connects a specific project to specific services. Describe the proposed building or alteration, location, available records, schedule and known constraints. Then identify the engineering tasks, deliverables, exclusions and decision points.

STRUCTURE's scope guidance recommends distinguishing work included in the fee, additional services, recommended services declined by the client and required services performed by others. Those distinctions provide a starting framework for reviewing a proposal.

For example, an existing-building evaluation might include a visual site visit and review of available drawings. Destructive investigation, material testing and assessment of concealed connections may require separate authorization. The report should make those limits clear rather than implying that every part of the building was examined.

A new-building proposal might cover structural design through construction documents while identifying separate allowances for submittal reviews and site observations. Ask how the construction phase will be supported and how changes will be authorized. A phase heading alone does not explain the depth of service.

The engineer can be retained through different arrangements

An owner may retain the structural engineer directly, or the engineer may be a consultant to the architect or participate under another project agreement. Direct owner engagement is not a universal requirement. AIA's consultant agreement guidance expressly includes agreements through which architects retain engineers.

The important questions are who holds the agreement, who coordinates communications and what responsibilities flow between the parties. A structural engineer's professional responsibilities do not disappear because the architect is the contracting client.

For manufacturers, this affects the route for technical questions. A contractor's request, an architect's inquiry and an engineer's design clarification may concern the same component but require different responses. Establish who needs the information and who will decide how it is used.

Architecture and structural engineering overlap through coordination

The architect develops architectural requirements and coordinates the design team as agreed. The structural engineer develops the structural system within the assigned scope. Geotechnical, civil, enclosure and building-services specialists contribute their disciplines. Exact responsibilities depend on the project and agreements.

These roles cannot be reduced to appearance versus strength. An opening affects spatial design, framing, connections, weather protection and sometimes fire performance. Useful coordination brings those requirements together without treating one participant as responsible for everything.

Site hazards change the questions, not the need for a clear scope

A hillside home, a flood-exposed property and an addition to an older building may require different investigations and design inputs. The proposal should identify the information required and who supplies it. A geotechnical report, survey and record drawings serve different purposes; none should be assumed to substitute for the others.

For wildfire-area projects, distinguish structural engineering from the broader work of reducing ignition exposure. Roofing, vents, exterior assemblies, site conditions and structural connections involve related but different requirements. The structural engineer is not automatically the sole professional responsible for every wildfire measure.

Likewise, seismic requirements cannot be inferred from a product brochure or a general regional description. Project location, adopted requirements, building configuration, site information and the selected structural system must be evaluated by the responsible professionals.

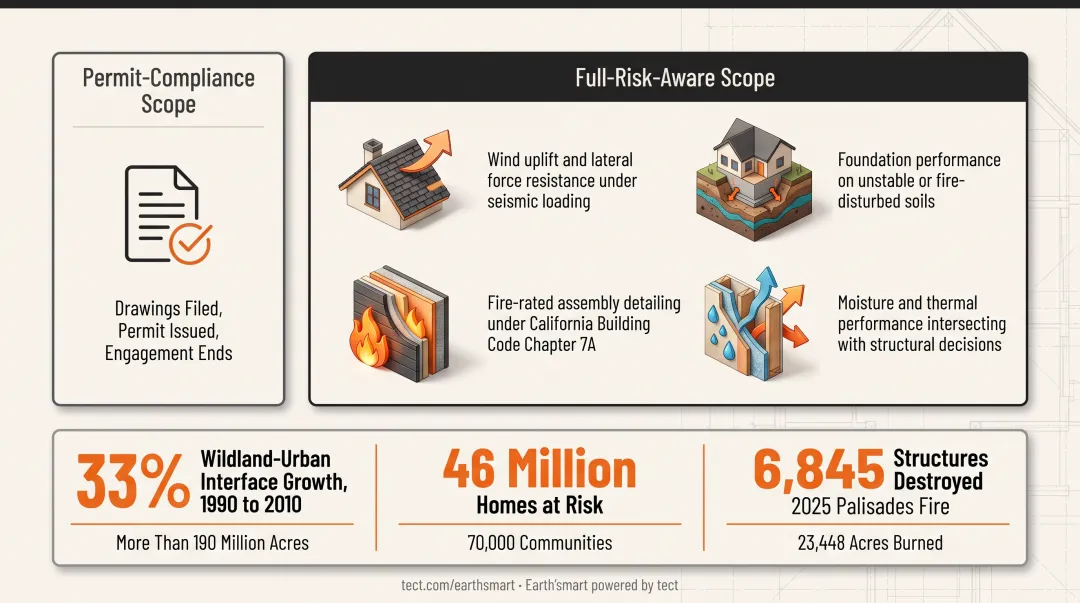

The accompanying graphic provides a broad historical WUI context. Population and land-area totals do not establish the risk, required engineering services or code classification of an individual property.

Wildland-Urban Interface growth statistics showing 46 million homes at wildfire risk

The practical scope question is therefore specific: which site and building conditions will this engagement evaluate, using what evidence, and what happens if the investigation reveals something different? That is more useful than assuming every hazard-exposed project needs an identical expanded package.

Manufacturers can support this work by identifying the conditions under which their data apply. A component's tested capacity, fire classification or installation detail may be valuable, but its relevance depends on the actual application. Explain the boundaries so the engineer can assess them.

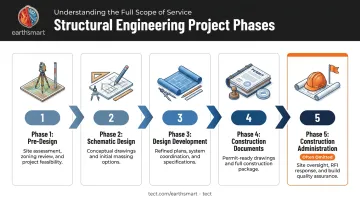

Structural services across five planning and delivery stages

Projects organize services differently. The following stages are a way to discuss scope, not a mandatory contract sequence or a promise that every proposal includes every task. Early feasibility, permitting and bidding support may also be listed separately.

1. Pre-design and feasibility: establish what is known

At this stage, the team identifies the proposed work and the information needed to assess it. For an alteration, that may include available records, an initial site review and questions about concealed construction. For new construction, it may involve the site, preliminary building configuration and potential structural systems.

Define the investigation before relying on its conclusions. Does the engineer review existing drawings only, visit accessible areas, coordinate testing or develop a more detailed assessment? Who arranges access and reinstatement where investigation requires opening finishes?

A manufacturer can clarify whether a proposed system has relevant documentation for the anticipated use. That is an initial feasibility contribution, not approval of the project. Record unresolved conditions so preliminary interest is not mistaken for final suitability.

2. Schematic design: compare structural approaches

The team considers how the building will carry vertical and lateral loads and how the structure relates to the architectural concept. The scope might call for preliminary layouts, system comparisons and coordination meetings rather than fully sized members and connections.

Useful comparisons explain consequences. A structural option may affect floor depth, openings, erection access, foundation demands or interfaces with other systems. The engineer and team decide which implications matter for this project.

Manufacturer input is particularly helpful when it answers an actual option question. Explain relevant dimensions, available configurations and limitations. If a proposed span or support condition falls outside published information, identify the need for further engineering rather than stretching a standard detail to fit.

3. Design development: resolve interfaces

The selected approach becomes more detailed. Framing layouts, member sizes and connections are refined as appropriate, while the team coordinates architectural and building-services requirements. NCSEA's design-process guidance describes structural design as coordinated and iterative across these phases.

For a manufacturer, this is a useful moment to explain installation access, fastening conditions, movement allowances and supporting-substrate requirements. Distinguish the information your company provides from calculations or decisions assigned to the project engineer.

An equipment opening illustrates the need. The equipment supplier may identify dimensions and operating information; the structural engineer evaluates the framing implications; other team members address services and enclosure interfaces. A coordinated question names the affected decisions and responsible parties.

4. Construction documents and permitting: make requirements actionable

The structural documents may include plans, details, notes, specifications and calculations needed for the agreed submission. The proposal should identify anticipated permit responses and the assumptions behind them. A substantial redesign after an owner change is different from clarification of the submitted design.

Drawings and written specifications should work together. Product requirements, testing, submittals and installation expectations should not depend on a conversation that never reaches the documents. If the design relies on a particular condition in a product report, make that condition traceable.

Manufacturers should provide current, identifiable documents rather than an undifferentiated download folder. Note the exact model or configuration, publication revision and relevant limits. The engineer needs to determine what supports the design, not guess which page was intended.

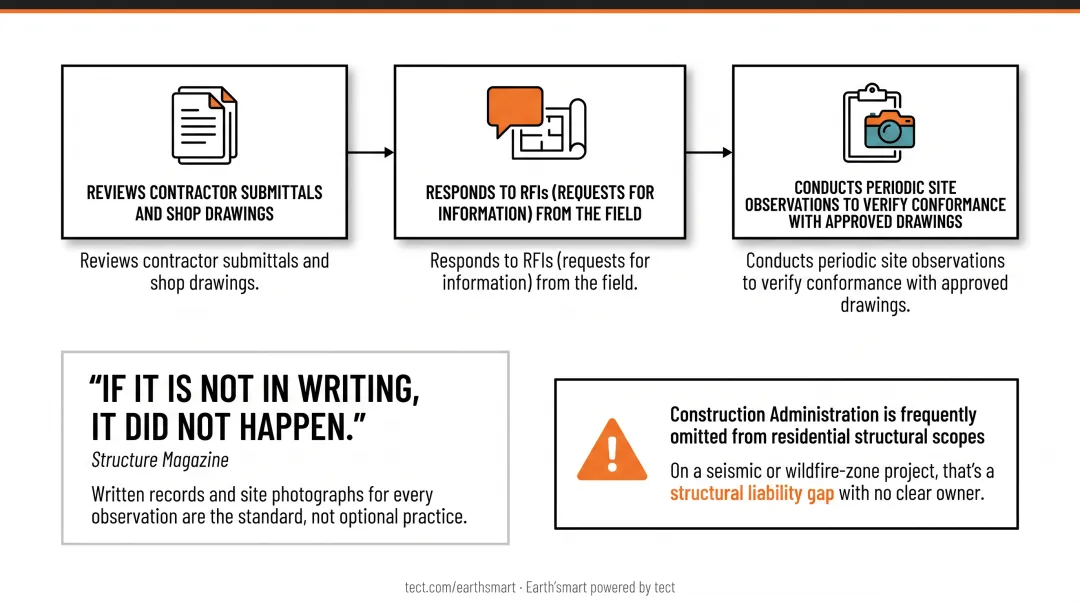

5. Construction support: address questions and document observations

Construction-phase work can include submittal reviews, responses to requests for information, evaluation of proposed changes and agreed site observations. Scope should describe the anticipated services and how additional visits or redesign will be handled.

Periodic observation is not continuous inspection of every component. Nor does it automatically replace special inspection, testing, contractor quality control or the building department's inspections. These activities have different purposes and responsibilities.

For a concrete local example, San Luis Obispo County's structural observation program explicitly states that structural observation does not replace required special or county inspections. Its documentation procedures are local requirements, not a nationwide template.

A manufacturer's field response should follow the project's communication process. If an installed condition differs from the published detail, document the difference and escalate it for appropriate review. A quick verbal reassurance should not silently become a design change.

Five-phase structural engineering services process flow from pre-design to construction administration

Exclusions need an assigned owner

An exclusion is not inherently a problem. It becomes a problem when necessary work is excluded from every agreement or when nobody recognizes that a separate service must be arranged.

Discuss geotechnical investigation, surveys, existing-condition testing, special inspection, peer review, construction-phase support and post-occupancy assessments as applicable. Avoid assuming that every engineer excludes these services or that every project requires all of them.

A simple responsibility schedule can make the discussion concrete:

Required decision or information Question to resolve before work proceeds
Existing structural condition What will be investigated, and what remains concealed?
Ground conditions Who supplies the geotechnical information and reviews its implications?
Product-specific connection design Who designs it, using whose criteria and review process?
Required testing and inspection Who arranges, performs, receives and addresses the reports?
Proposed substitution Who evaluates its effect on the existing design and documents the decision?

The schedule complements the agreements; it does not rewrite them. Keep the language consistent with the actual appointments and obtain professional advice where contractual responsibilities need clarification.

Delegated design deserves an explicit interface

Some projects assign defined component design to another qualified professional or specialist under specified requirements. That arrangement needs clear criteria, deliverables, review responsibilities and coordination. It should not arise accidentally because a catalog detail was included in a submittal.

Ask what loads and other criteria the project engineer supplies, what the delegated designer must produce and how the component connects to the primary structure. Identify who handles supporting elements and interfaces outside the component supplier's work.

A manufacturer may provide technical data, engineering services under a separate scope, or neither for a particular condition. State which applies. A sales representative's willingness to help is not a substitute for an agreed engineering appointment.

A product substitution shows why scope matters

Consider a hypothetical home project with an engineered connection system shown in the structural documents. During procurement, the contractor proposes a different product because the specified option is unavailable within the desired schedule.

The replacement's headline capacity appears comparable. That is enough to start a review, not enough to establish equivalence. The engineer may need information about the substrate, fasteners, installation conditions, applicable report provisions and interaction with the rest of the design.

The manufacturer should assemble a focused response: exact proposed product, relevant evidence, identified differences and unresolved conditions. If the available information does not cover the proposed use, say so. An incomplete but candid response is more useful than a declaration that two products are interchangeable.

The project team then needs a defined route for evaluation. Who requests the change? Who reviews structural effects? Are revised details required? Does the review fall within the existing appointment or require additional authorization? Who communicates the accepted decision to the installer?

After the decision, retain the relevant documentation with the current project information. A favorable technical conversation does not update drawings, authorize installation or confirm that the product was installed correctly. Each step needs its own responsible participant.

This example does not imply that substitutions are always undesirable. A well-supported alternative may be appropriate. The point is that product availability, engineering review and construction authorization are different decisions, even when they occur close together.

Compare proposals using the same project assumptions

Two fees are not directly comparable if one proposal includes construction support and another stops after permit documents. Ask each firm to respond to the same description of the project, available information, anticipated schedule and required services.

Review deliverables, meetings, site visits, permit responses and exclusions. Ask how existing-condition uncertainty, owner changes and contractor substitutions will be handled. If the scope uses an allowance, clarify what it covers and how additional work is authorized.

For manufacturers engaged by the project, make your own support scope equally understandable. Separate standard technical assistance from project-specific engineering, testing, travel or other services that require separate agreement. Do not let a helpful preliminary email imply an unlimited undertaking.

A short written record of assumptions makes later discussions more constructive. When a condition changes, the team can identify which assumption changed, what decision is affected and who needs to respond. That is better than debating whether a broad phrase included every possible task.

Before authorizing work, also identify the person who can approve a scope change. A field question may need a prompt answer, but the engineer and client still need a workable authorization process. Agree how urgent questions will be communicated, what information must accompany them and how decisions will be recorded for the wider team.

Correct three common scope assumptions

The architect cannot retain the structural engineer. The appointment can take several forms. What matters is that agreements, responsibilities and coordination are clear, not that every engineer contracts directly with the owner.

Permit approval finishes the engineering process. Approval of documents does not establish that the construction matches them. Confirm required and contracted construction-phase services, along with testing and inspection responsibilities.

There are only four structural load categories. Simplified teaching groups are not a complete design checklist. ASCE's public description of ASCE/SEI 7-22 includes dead, live, soil, flood, tsunami, snow, rain, atmospheric ice, seismic, wind and fire hazards and load combinations. The applicable edition and project requirements must be established by the responsible professionals.

ASCE 7-22 structural load categories comparison chart for residential and WUI projects

A WUI location is not a single structural load category. The accompanying chart should be understood alongside the broader distinction between structural loading, fire exposure and the requirements for particular products or assemblies.

Make manufacturer expertise accessible without taking over the design

A structural team may find the product data quickly and still struggle to reach someone who understands the limitation behind a detail. The valuable contribution is often a focused explanation of an application, interface or missing piece of evidence.

tect helps participating manufacturers make that expertise easier to find through tectApp™. Project professionals can browse by category and project location and initiate direct contact with relevant experts. Coverage is selective; discovery does not guarantee a specification or purchase.

For your company, the useful preparation is to identify who can answer structural-product questions, which territories they serve and when they should escalate a question. Their role is to support informed decisions while the engineer retains project design responsibility.

Discuss manufacturer participation with tect if making that technical knowledge accessible would improve how your team supports project professionals.

Questions to settle before signing

Does every structural scope include site visits?

No. Confirm the intended investigations, construction observations and any required inspections separately. The agreement and applicable requirements determine what must be arranged, by whom and at what stage.

Is coordination automatically an additional service?

No. Some coordination is part of the agreed work; other tasks may require additional authorization. Ask the engineer to explain the proposed boundaries rather than assuming either unlimited coordination or no coordination at all.

Can a manufacturer approve the structural design?

Product expertise does not replace the responsible professional's project evaluation. A manufacturer may perform specific engineering services under an appropriate arrangement, but that role and its interfaces must be expressly defined.

When should the structural engineer become involved?

Engage the appropriate expertise while important system decisions can still be evaluated. The necessary timing depends on the project, but waiting until drawings are ready for submission can leave less room to resolve structural implications constructively.
